Blue Moon
Blue Origin’s landers: the robotic Mk1 for cargo and the crewed Mk2, NASA’s second Artemis lander.
- Status
- In development
- Height
- 16 m
- 52 ft
- Built by
- Blue Origin
Blue Moon: NASA’s second crew lander and the cargo lander that goes first
Drawn from 21 sources: NASA (9), Spaceflight Now (3), NASA Marshall Space Flight Center (2), NASA Office of Inspector General and 6 others. About 8 minutes. Checked November 9, 2026.
Blue Moon is two landers. Mark 1 is a robotic cargo lander, nearly three stories tall, built to carry up to 3 tons to the Moon; Blue Origin is paying for its first flight itself. Mark 2 is the larger crew lander that NASA has contracted for Artemis: about 52 feet tall, with a cabin for two astronauts at its base. Both burn liquid hydrogen and liquid oxygen in Blue Origin’s BE-7 engines, and both launch on Blue Origin’s New Glenn rocket from Florida.1,4,5,7
The smaller lander exists to buy down risk for the larger one. Blue Origin follows a block-upgrade approach, adding capabilities with each lander. Before its crewed lander flies, it plans two Mark 1 missions that land on the Moon and demonstrate critical systems: propulsion, the handling of super-cold propellants and precision landing. Then a Mark 2 is to make an uncrewed demonstration landing before carrying a crew.1
$3.4 billion for a second way to the surface
NASA chose SpaceX’s Starship in 2021 as its only lander because it could afford only one. To keep competition and a backup, it issued a second solicitation in September 2022, open to all U.S. companies other than SpaceX, for a lander that would meet its requirements for recurring missions: docking with the Gateway station, carrying more crew, staying longer and landing more mass.1,2 On May 19, 2023, NASA selected Blue Origin of Kent, Washington. Blue Origin would design, develop, test and verify Blue Moon to those requirements, fly one uncrewed demonstration mission to the surface, and then carry a crew on Artemis V, then planned for 2029. The firm-fixed-price contract was worth $3.4 billion.2
Having two distinct lunar lander designs, with different approaches to how they meet NASA’s mission needs, provides more robustness and ensures a regular cadence of Moon landings.
Blue Origin leads a group of companies it calls the National Team. When the contract was awarded, its partners were Lockheed Martin, Boeing, Draper, Astrobotic and Honeybee Robotics. Blue Origin has since restructured the team to use components common to Blue Moon and New Glenn.1,3 In 2024 NASA allowed Blue Origin to delay its critical design review in exchange for formally adding a test of liftoff from the lunar surface to its uncrewed demonstration, along with more insight for NASA, at no added cost.1 How little both lander contracts have grown under their fixed prices is part of the Artemis plan.
How the two landers work
Mark 1, a robotic cargo lander
Mark 1 is uncrewed and launches on New Glenn. Blue Origin built it to demonstrate its BE-7 engine, precision landing and autonomous guidance, navigation and control; the first one is named Endurance.4,5 A development BE-7 was fired in a vacuum chamber at the Air Force Research Laboratory’s facility at NASA Armstrong.1,3
Mark 2, a crew lander about 52 feet tall
Mark 2 will meet Orion in lunar orbit and ferry two astronauts to the surface and back. Its cabin sits at the base, so the crew climbs stairs about 6 feet to the ground instead of riding an elevator.7,1 It was to be refueled on the way; in October 2026 NASA said Blue Origin would defer propellant transfer and instead use three transfer stages, each separating as its propellant runs out, to reach an elliptical polar orbit that allows faster returns from the surface to Orion.1,19
A cabin for two, and the cold hydrogen
The cabin is where two astronauts will eat, sleep and conduct science. Its airlock must hold a station for putting on and taking off spacesuits; Blue Origin designed one for a NASA reference suit, then learned that Axiom Space’s suit uses a different connection, so the airlock or the station has to change.7,1 The tanks hold the harder problem: storing hydrogen in space with little or no boiloff is one of Blue Origin’s most significant technical challenges.1,3

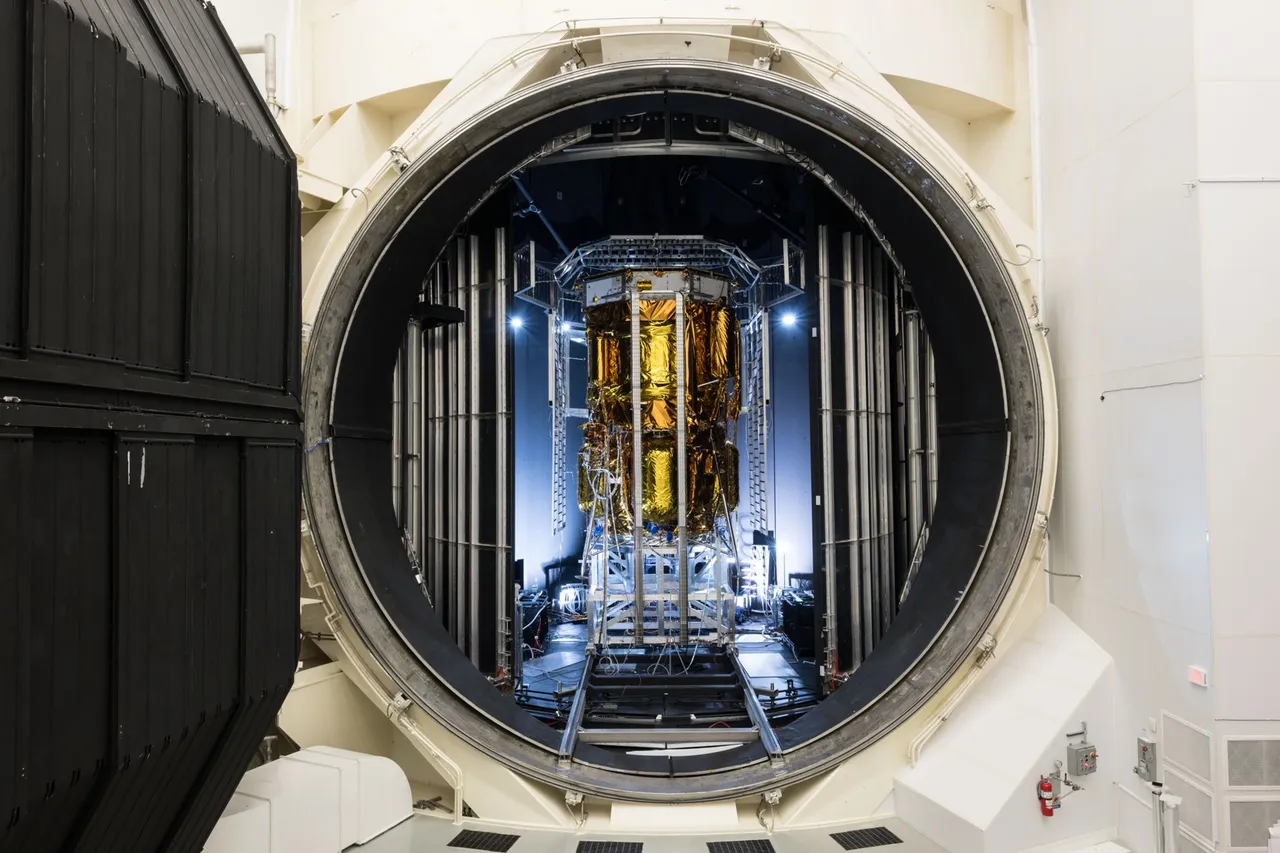

Endurance, the first Mark 1, passes its tests in Johnson’s Chamber A

In the spring of 2026 Blue Origin finished environmental testing of Endurance inside Thermal Vacuum Chamber A at NASA’s Johnson Space Center in Houston, one of the world’s largest thermal vacuum facilities. The chamber recreated the vacuum of space and the extreme temperatures the spacecraft will meet in flight, so that engineers could evaluate how its systems performed and verify its structural and thermal integrity before launch. Blue Origin did the work under a reimbursable Space Act Agreement, paying NASA for the use of the facility.5
Endurance carries two NASA payloads under the CLPS program: the Stereo Cameras for Lunar Plume-Surface Studies, an array of high-resolution cameras that will photograph how the engine plume disturbs the lunar surface during descent and landing, and the Laser Retroreflective Array, which helps orbiting spacecraft fix their position with reflected laser light.5 NASA has named the flight Moon Base I, the first mission of its Moon Base campaign, and plans to land it on the Shackleton Connecting Ridge near the South Pole to reduce risk for the crewed landings.6

By August 2026 the lander’s structure, propulsion elements and avionics were fully assembled. It had completed communications checks with NASA’s Tracking and Data Relay Satellite System and Deep Space Network, and engineers were next to verify the wiring that connects the payloads. Loading cryogenic propellants was to be one of the last tests before it is integrated with its rocket.9
Mark 1 is also becoming NASA’s cargo truck. In September 2025 NASA ordered a second Mark 1, now in production, to deliver the VIPER rover to the South Pole region in late 2027, a task order worth up to $190 million. NASA will decide whether to exercise the delivery option after reviewing Endurance’s flight.10 In May 2026 NASA awarded Blue Origin the delivery of the first crewed lunar rovers, built by Astrolab and Lunar Outpost; in October it said the rovers were to reach the South Pole region by 2028.6,18 On November 7 NASA expanded that order to include a Mark 1 that will deliver PROMISE to the South Pole, a nuclear-powered rover that JPL will build from spare parts and test models made for the Curiosity and Perseverance Mars rovers. It is to launch in late 2028 for an 18-month mission.20 What NASA is paying for the 2026 orders is in CLPS.
Mark 2: a training cabin at Johnson and a test lander for 2027

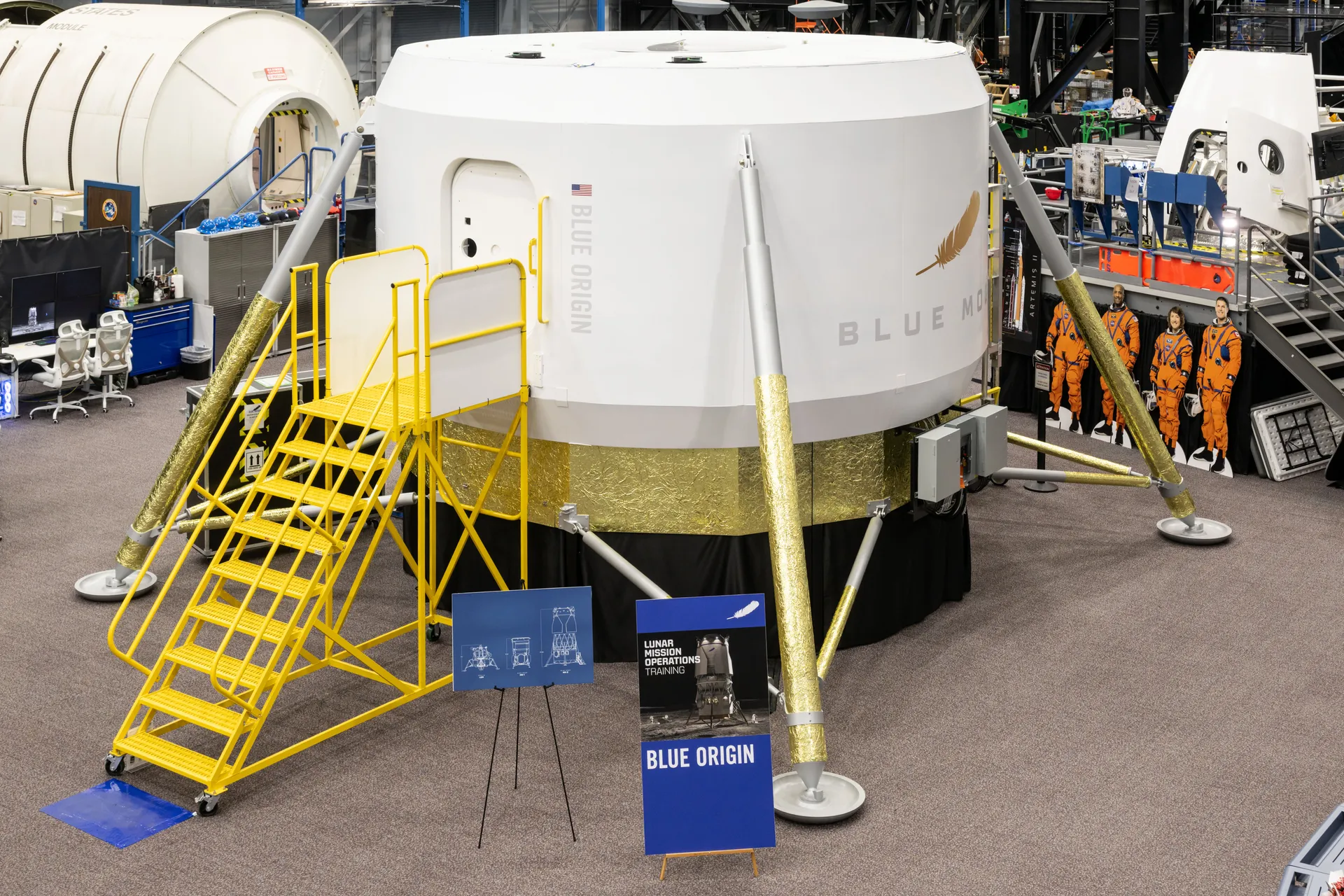

Since May 2026 a full-scale mockup of the Mark 2 crew cabin, over 15 feet tall, has been in use at Johnson’s Space Vehicle Mockup Facility. It has the exterior ladder astronauts will use on the Moon, and NASA and Blue Origin use it inside and out for tests with people in the loop: mission scenarios, communications with mission control, spacesuit checkouts and rehearsals of moonwalks. Over time it is to become an integrated simulator, and it feeds design comments back to Blue Origin.7 In February 2026 Blue Origin finished testing the soft-capture system of the lander’s pressurized docking mechanism at Johnson.12
The design is not finished. At the preliminary review NASA found that Blue Origin needed to mature its propulsion system, reduce mass and improve its propellant margins.1
The schedule NASA’s lander program manager, Steve Creech, presented in October 2026 brought the uncrewed demonstration forward: a critical design review for the 2028 landing mission around the turn of the year, and the launch of the uncrewed Mark 2 at the end of 2027 or early in 2028, for a demonstration mission in the first quarter of 2028.17 Under the revised plan that flight is to demonstrate the full three-stage mission profile, and Blue Origin has added milestones for human-in-the-loop testing and hardware readiness.19
The restructured Artemis program has given Mark 2 an earlier first flight. For Artemis III in 2027, Blue Origin will fly a test lander based on its current Mark 2 design, with the major avionics, flight software and controls, life support and a crew cabin, so that operations can carry over directly to crewed lunar flights. It launches first and can loiter up to 30 days for checkouts. Orion will dock along its side, next to the cabin, with Orion’s software controlling the joined spacecraft, and up to two astronauts in orange Orion survival suits will open the hatch and go inside. An instrumented spacesuit mass simulator will report on conditions in the cabin.11 Further out, NASA intends to give Blue Origin a cargo job for a version of the crew lander able to land about 15 metric tons: delivering a surface habitat to the Moon, no earlier than fiscal year 2033.17
A pad explosion leaves every Blue Moon waiting on New Glenn

Every Blue Moon depends on New Glenn. In 2025 the rocket reached orbit on its first launch, in January, and in November its reusable first stage landed on a barge in the Atlantic.1 On April 19, 2026, the third New Glenn reflew and landed a used first stage, but its satellite payload ended up in the wrong orbit.13 On May 28, a New Glenn exploded during a static-fire test and heavily damaged Launch Complex 36, Blue Origin’s only orbital launch site. In August Blue Origin traced the cause to the main oxygen valve on one of the first stage’s BE-4 engines and said modified valves could be retrofitted quickly.15 It is rebuilding the pad to assemble rockets horizontally and lift them upright with a crane, and had aimed to fly again before the end of 2026.14 On November 4 its chief executive, Dave Limp, told employees in a memo reported by CNBC that the rebuild, slowed by summer weather, had moved New Glenn’s return to flight to January 2027.21
Endurance had been slated to fly as soon as late summer 2026. At a NASA briefing on June 30, Moon Base program executive Carlos García-Galán said the agency was looking at all its options, including whether the Mark 1, which was not involved in the accident, could fly on a different rocket. Administrator Isaacman said that New Glenn remained “Plan A.”14 Blue Origin’s John Couluris said the company would keep the first lander stored until New Glenn was ready, and expected the launch in the first quarter of 2027, followed by serial numbers two, three and four.15 NASA’s Moon Base manager listed Endurance for “the first part of 2027” in September, and the schedule NASA showed in October, before that memo, still had it flying in the first quarter of 2027.16,17
When Blue Moon would land1
2023202620282031
First Mark 1 landing (Endurance)
- Said Mar 20242025
- Said Jun 2026Early 2027
Uncrewed Mark 2 demonstration landing
- Said Mar 2026Feb. 2029
- Said Oct 2026Early 2028
First crewed Blue Moon landing
- Said May 20232029
- Said Dec 20242030
- Said Jul 20262028
In October 2025 NASA asked Blue Origin, as it asked SpaceX, how it could speed up its lander for a 2028 landing, and GAO reported that NASA officials said the agency could attempt two crewed landings in 2028, one with each company’s lander.1,8 In October 2026 NASA said neither company is assigned to a specific landing: lander readiness will decide which lands first.19
